Family owned since 2007Ajax · Durham Region · Greater Toronto Area5.0 on Google
What’s your next chapter?

Good homes start
with a conversation.

james@jarviscontracting.ca(289) 892-4169Home additions & renovations
Durham Region & the Greater Toronto Area

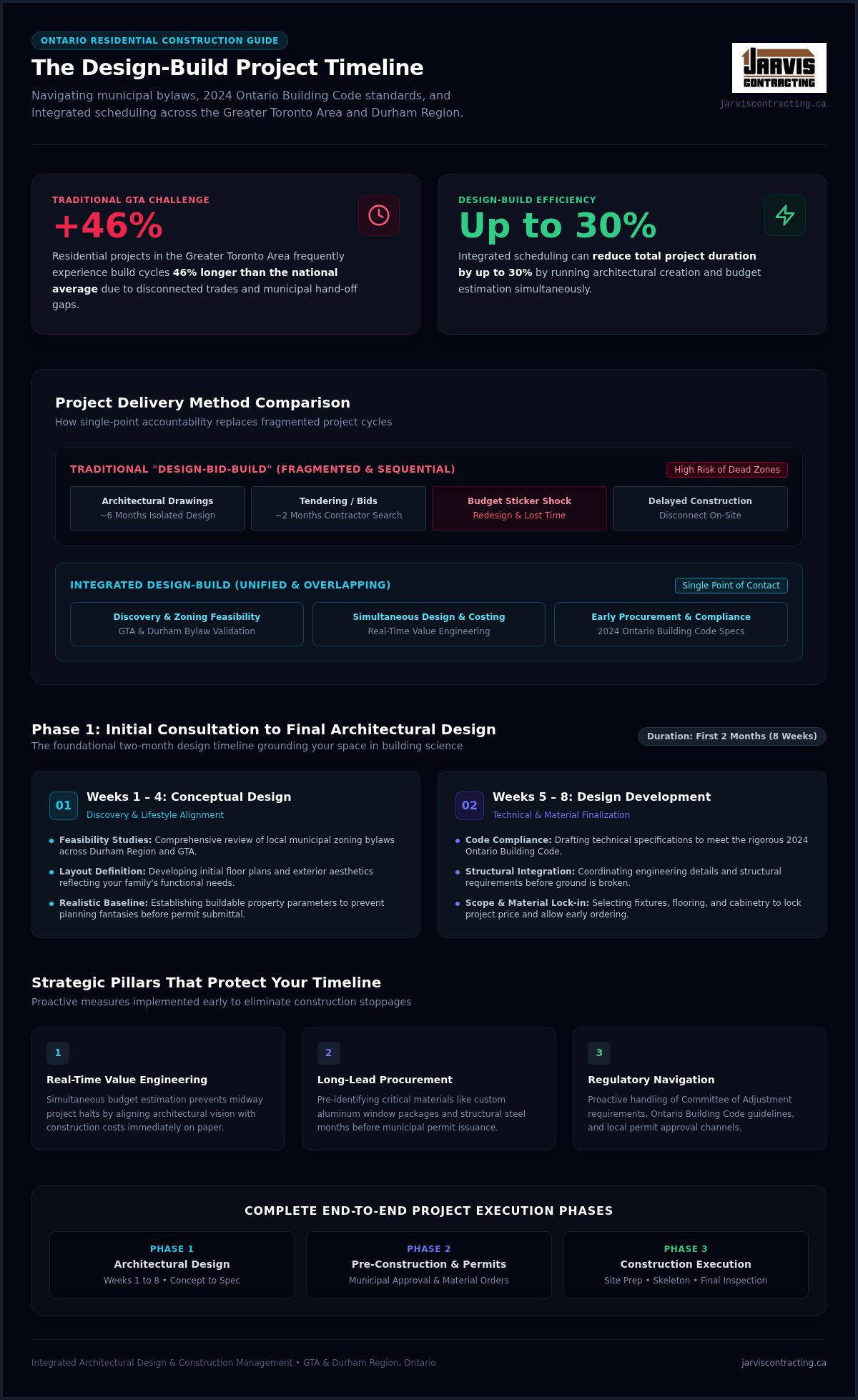

A design-build timeline has two different clocks: preparation before the site starts, and construction after it starts. Ask which one a quoted duration describes. A construction estimate does not automatically include design revisions, approvals, product lead times or work needed before the permit application is complete.

Start with the decisions that unlock the next stage

The first stage defines the problem: which rooms do not work, what space is needed and what can reasonably change. Measured information and a design brief come before detailed finishes.

Next, the layout has to settle enough for structural, mechanical and permit work to proceed. Choosing appliances after the cabinets have been ordered can reopen a decision that appeared finished. A useful schedule shows these dependencies, not just a row of dates.

Ask for milestones, not one finish date

MilestoneWhat to agree
Scope and conceptRooms, priorities and the working budget
Design decisionsLayout, major fixtures and structural approach
Permit packageWho prepares, submits and answers questions
ProcurementWhich products must be ordered before site work
ConstructionSequence, inspections and access arrangements
HandoverDeficiency list, documents and warranty information

A milestone is useful when it has a clear completion condition. 'Kitchen design complete' should mean an agreed drawing and selections, not simply that a meeting took place.

Two Jarvis projects, two different clocks

Greenwood took about ten months including design and permits. Its scope included a new top storey, rear extension and interior work. West Lynde involved about four and a half months on site to take a bungalow to two storeys. Those durations describe different scopes and starting points; neither is a promise for another house.

Use the cases to ask better questions: what was included before the site opened, what information was available, and which part of the work controlled the completion date?

Build a schedule you can use at home

Record when the kitchen or bathroom becomes unavailable, whether the house can be occupied during each phase, where belongings will be stored and who needs access. Ask what would happen if a key item arrived late.

At each update, distinguish a changed sequence from a changed finish date. Some tasks can be reordered; others depend on an inspection or a delivered component. Start with our project process, then talk to James about the actual scope of your home.

Questions

Can I get a firm timeline before the design is complete?

You can discuss an initial sequence and likely constraints, but a detailed programme needs a settled scope and a clearer view of approvals, products and site conditions. Ask what assumptions the estimate depends on.
